Highway Works Progress

Track the progress of highway works supporting the West Hendon masterplan, with key infrastructure improvements and traffic enhancements.

Construction Sequencing Plans

Visual timeline showing how construction phases develop over time. Click any thumbnail to view the full plan.

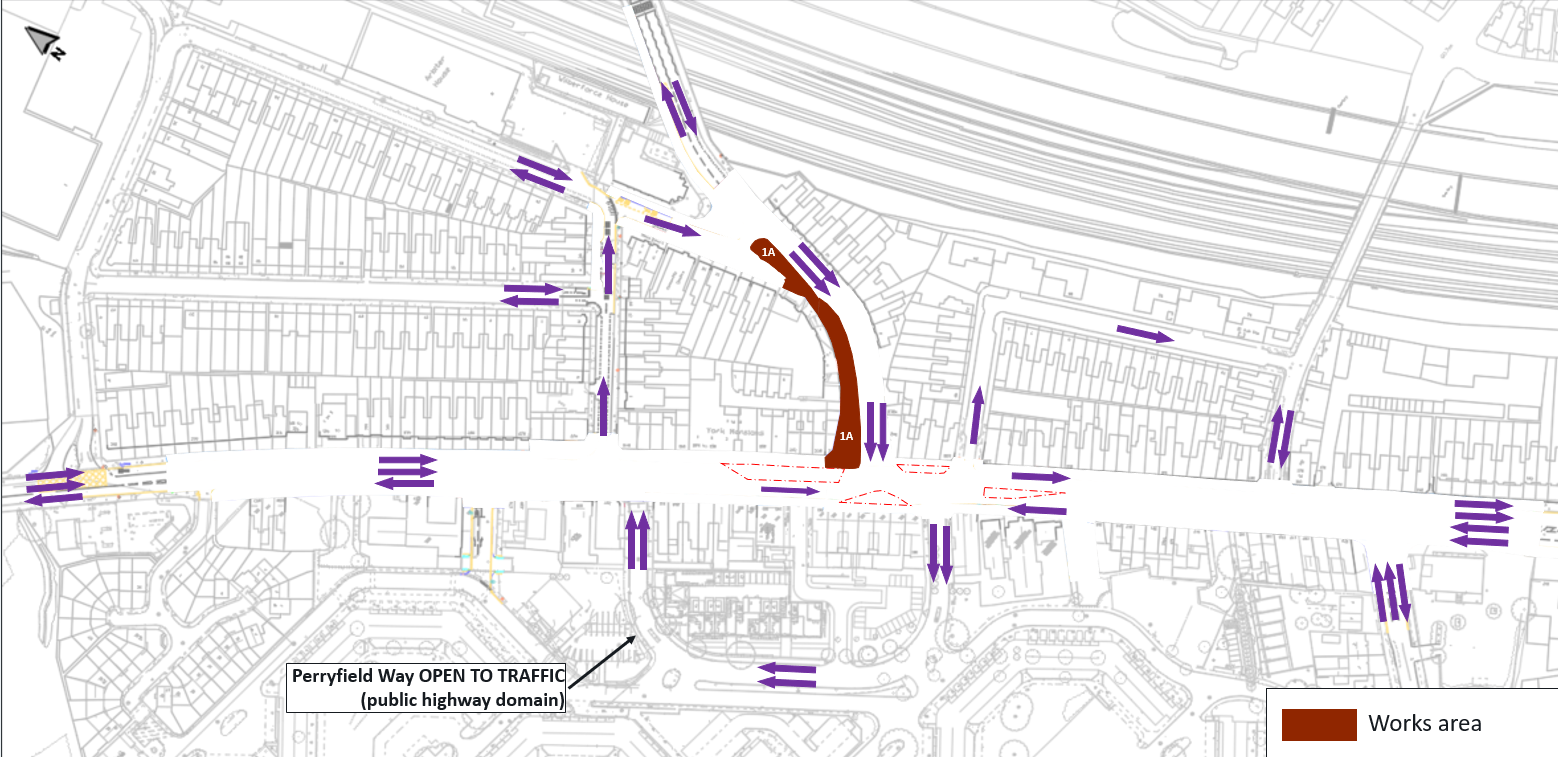

Construction progress plan thumbnail for Oct 2024

Oct 2024

Click to view full plan

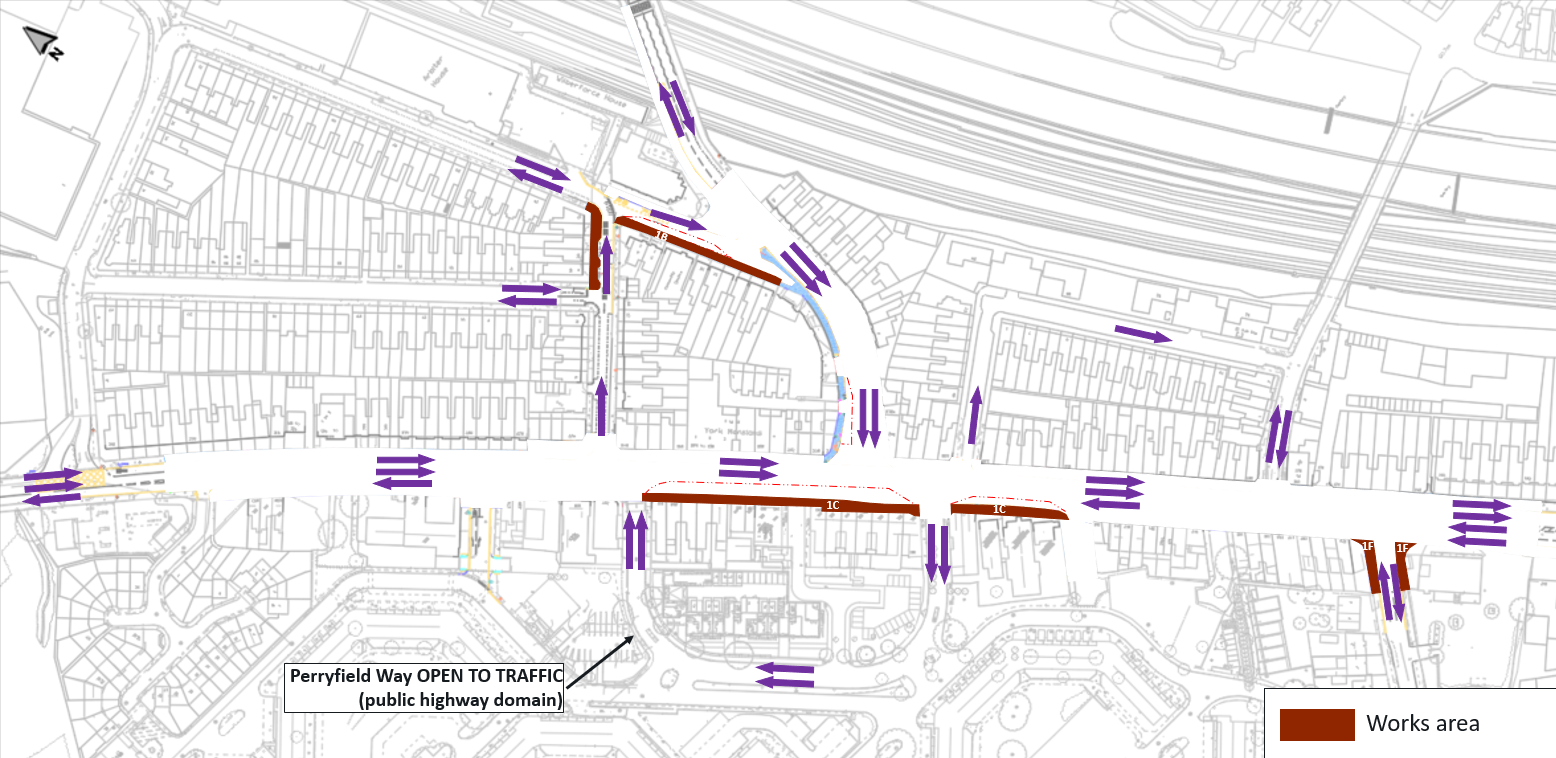

Construction progress plan thumbnail for Jan 2025

Jan 2025

Click to view full plan

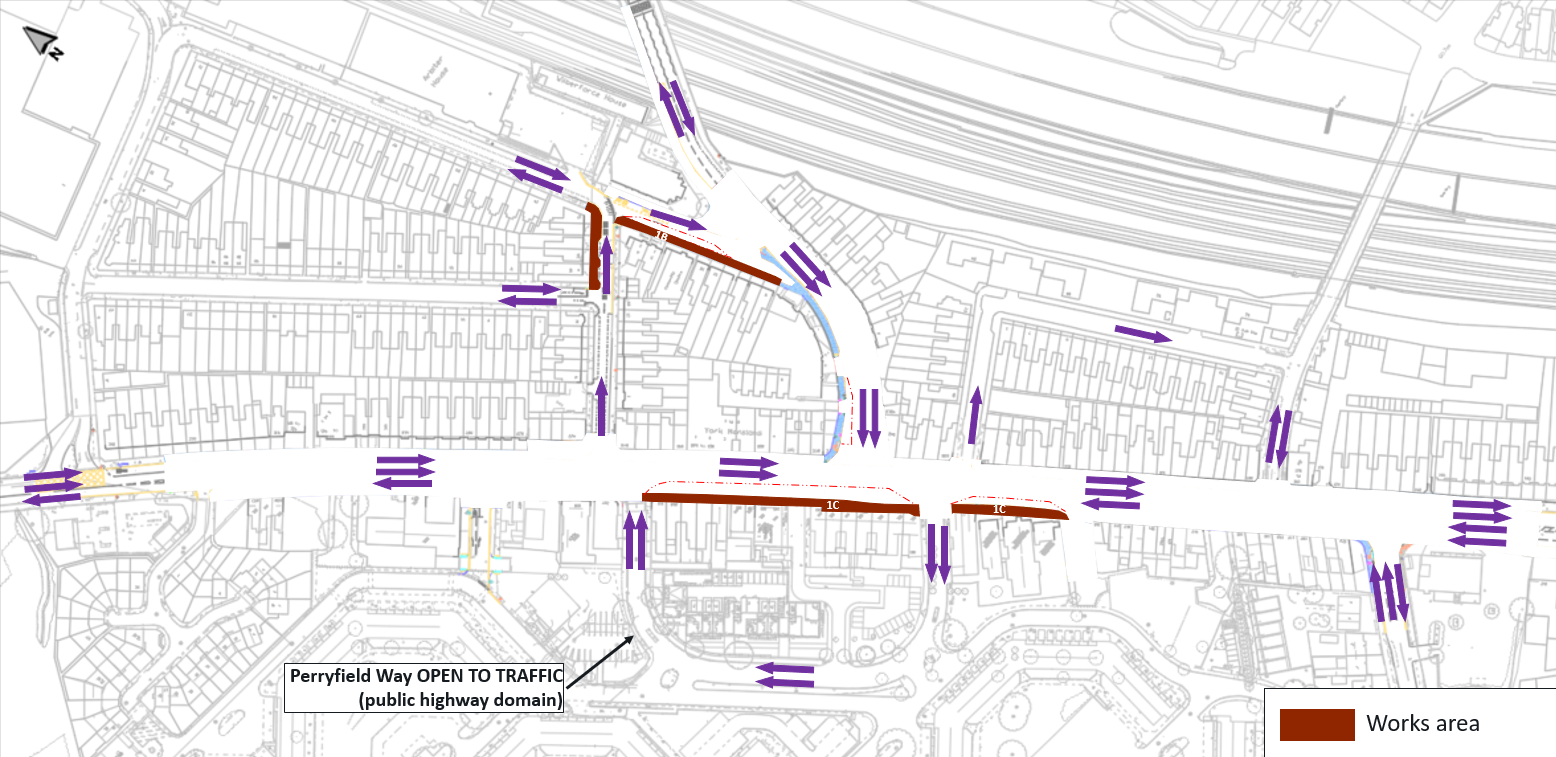

Construction progress plan thumbnail for Feb 2025

Feb 2025

Click to view full plan

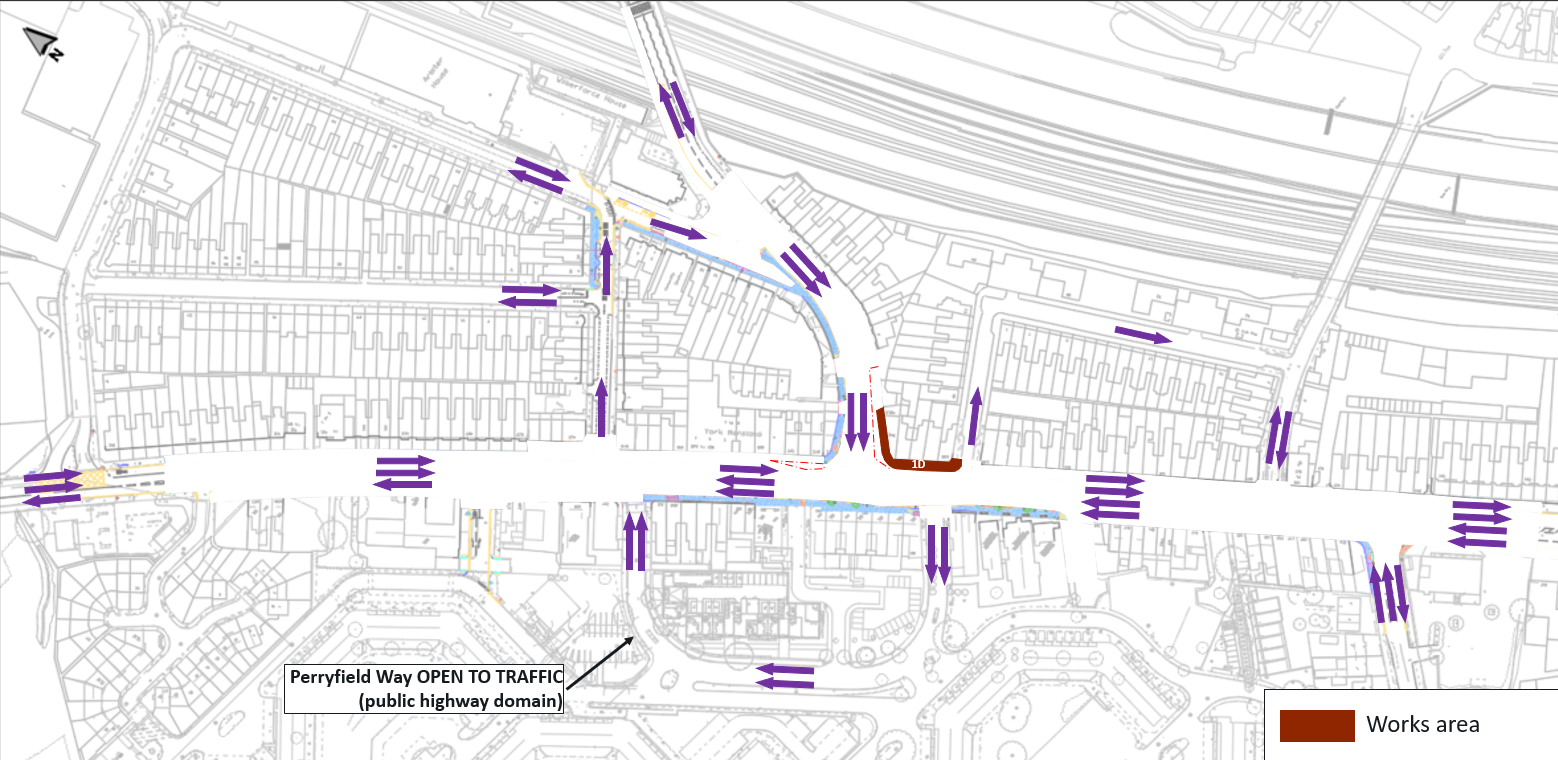

Construction progress plan thumbnail for Mar 2025

Mar 2025

Click to view full plan

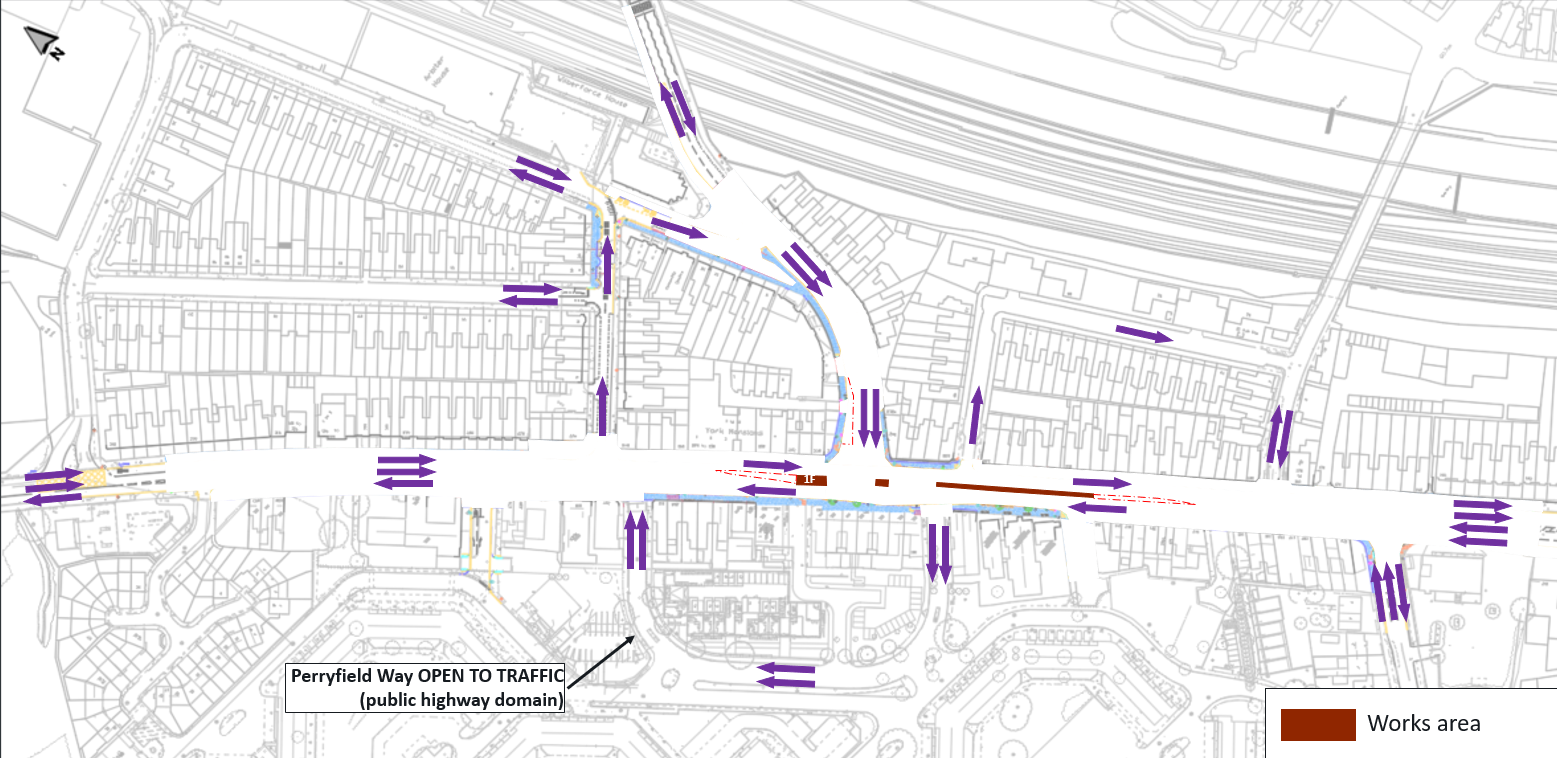

Construction progress plan thumbnail for Apr 2025

Apr 2025

Click to view full plan

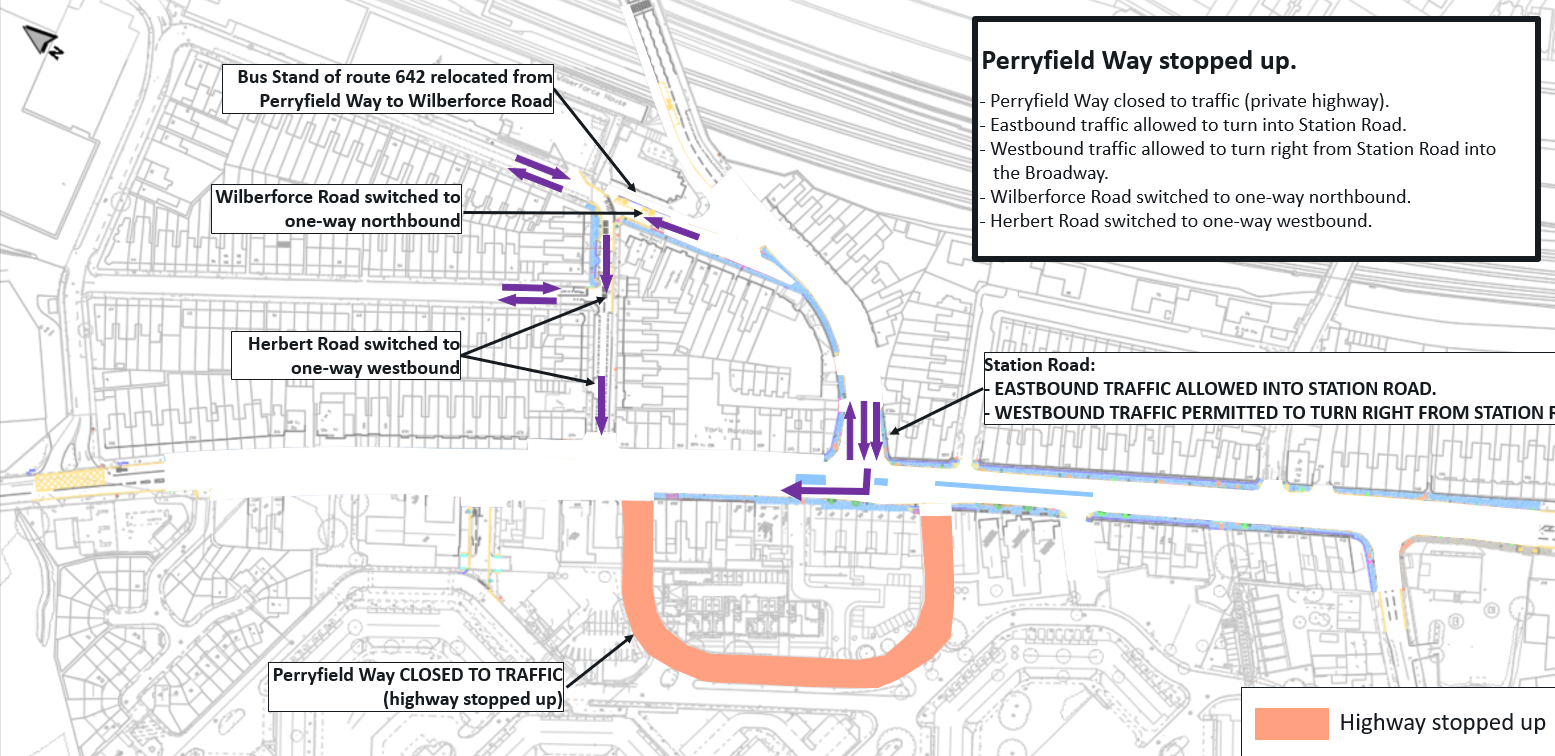

Construction progress plan thumbnail for May 2025

May 2025

Click to view full plan

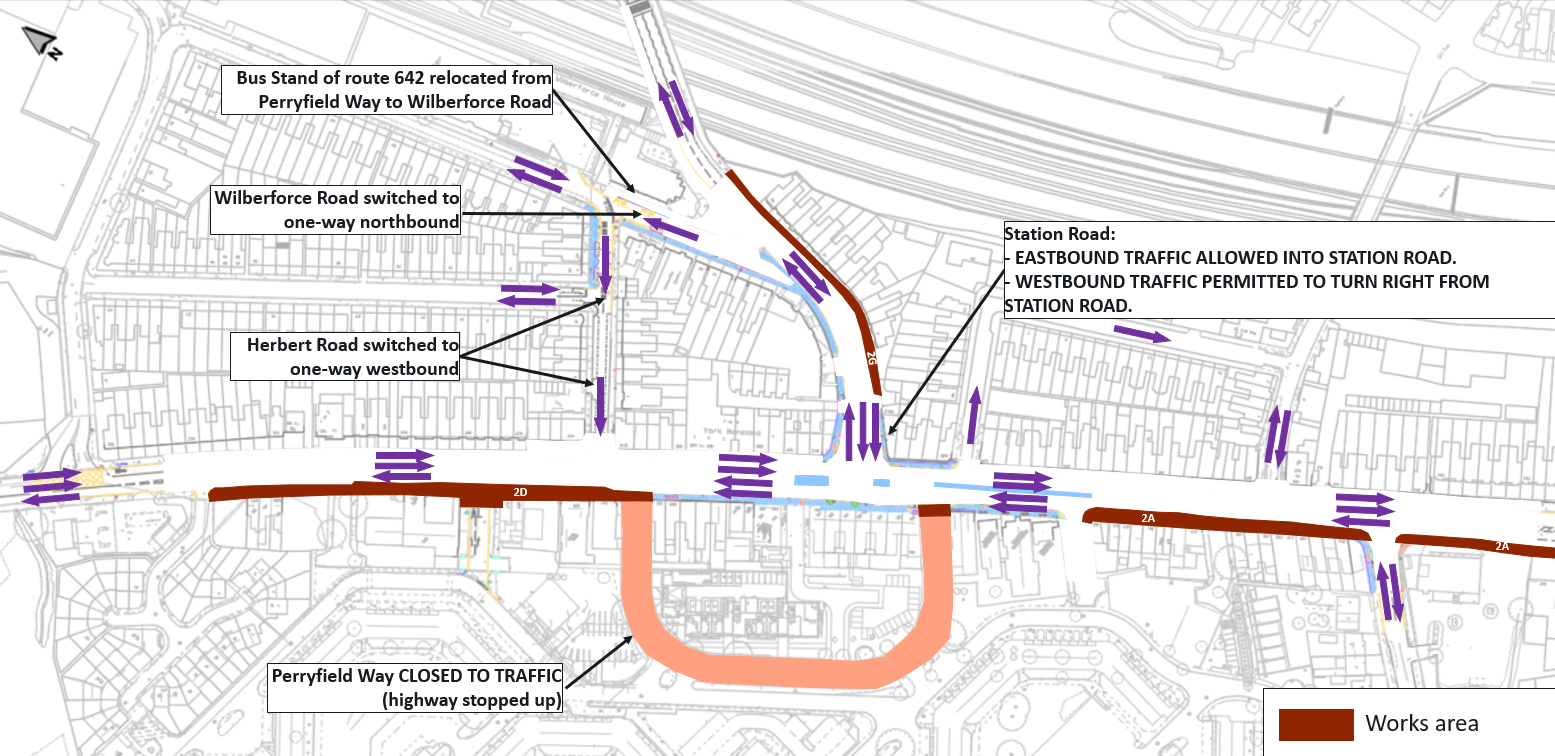

Construction progress plan thumbnail for May 2025

May 2025

Click to view full plan

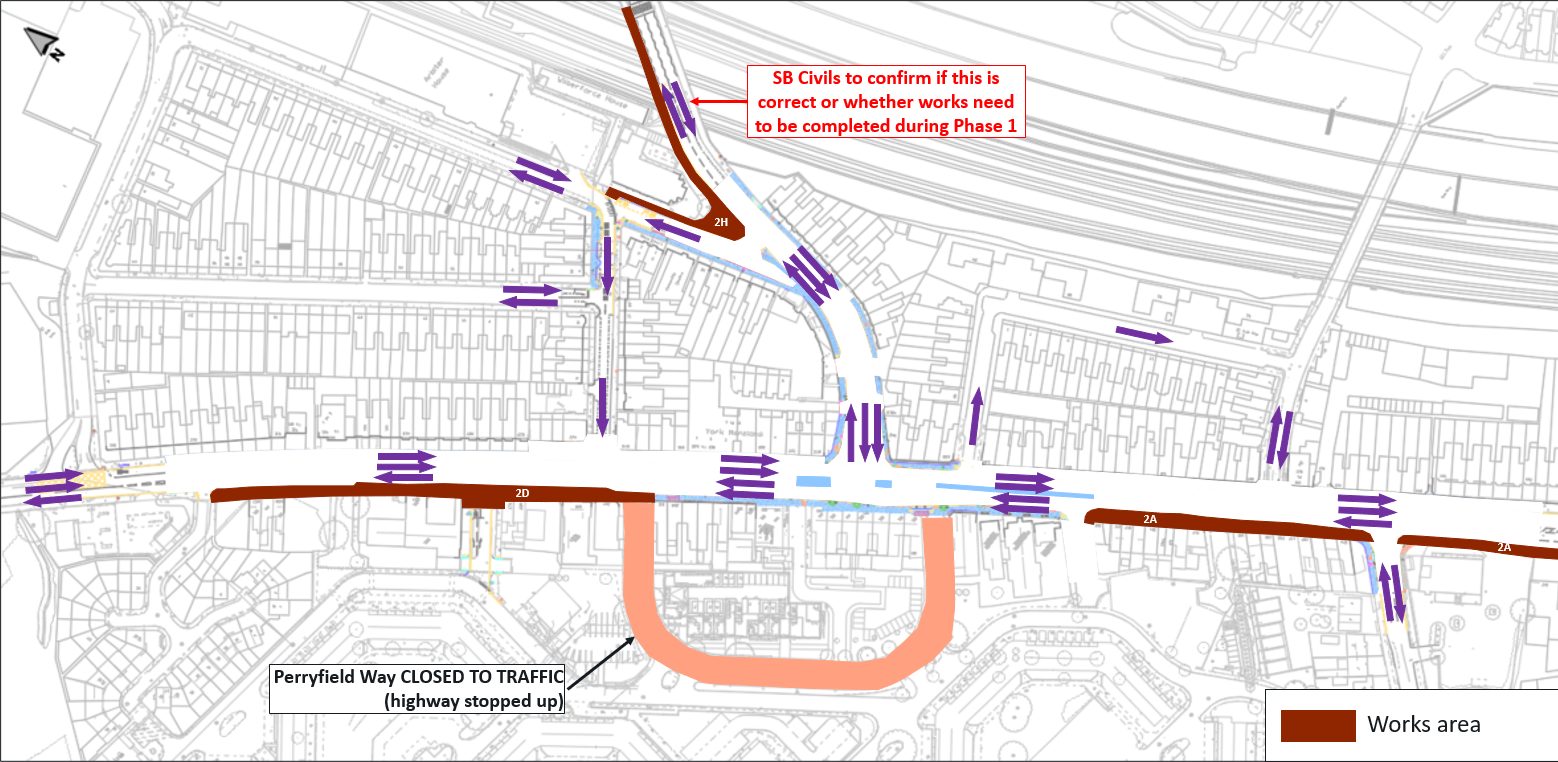

Construction progress plan thumbnail for Jun 2025

Jun 2025

Click to view full plan

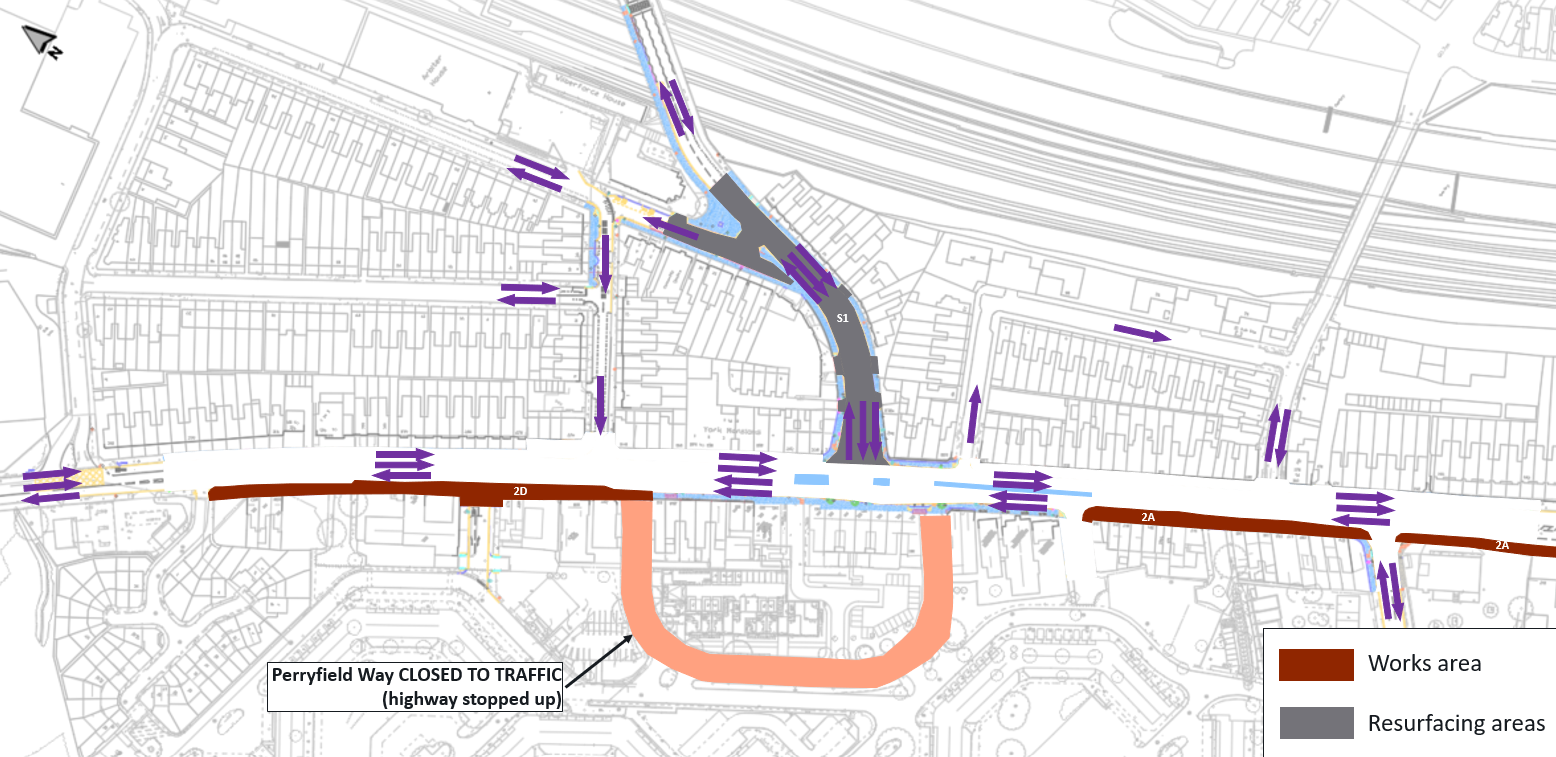

Construction progress plan thumbnail for Jul 2025

Jul 2025

Click to view full plan

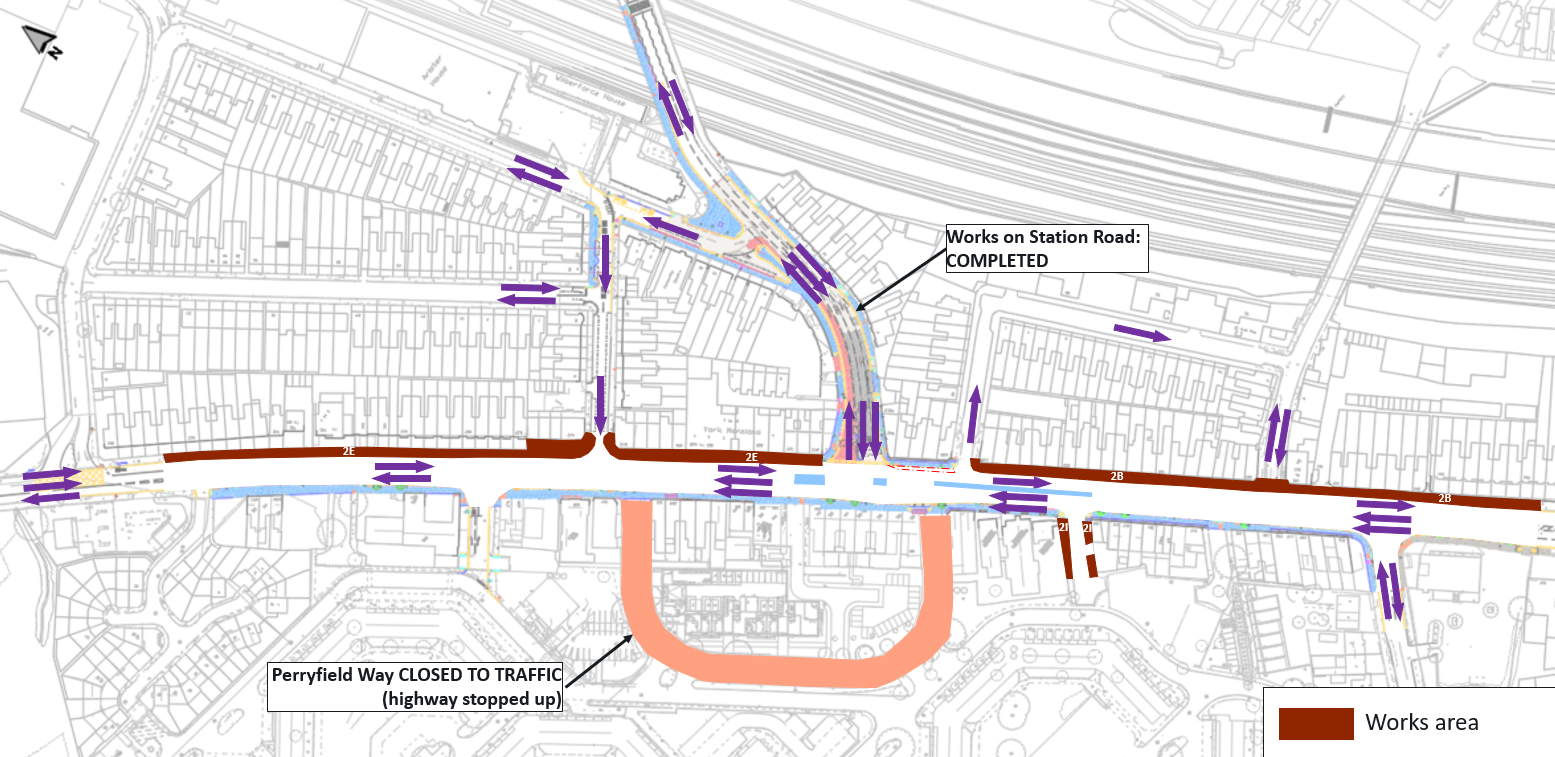

Construction progress plan thumbnail for Aug 2025

Aug 2025

Click to view full plan

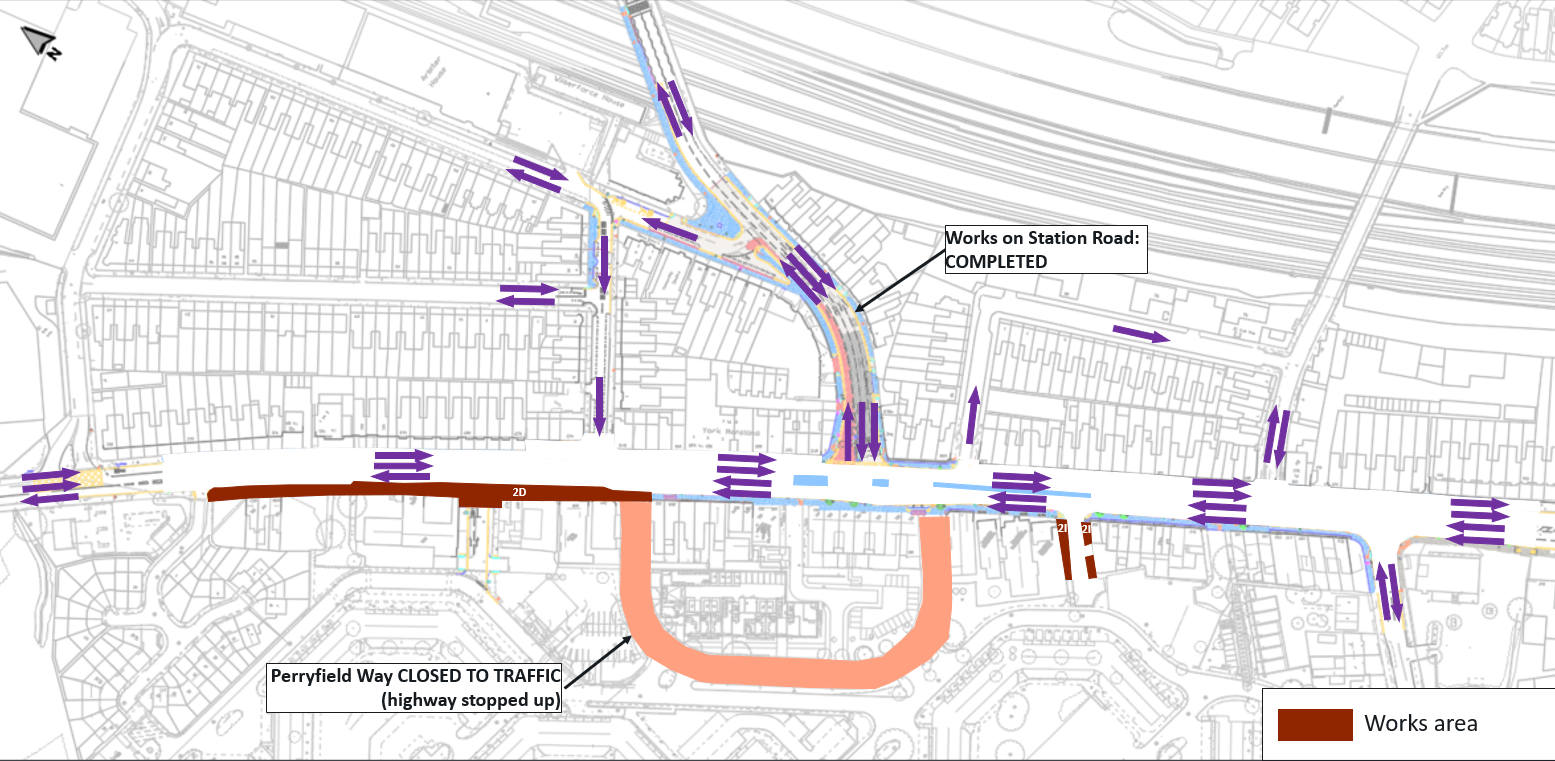

Construction progress plan thumbnail for Aug 2025

Aug 2025

Click to view full plan

Construction progress plan thumbnail for Sep 2025

Sep 2025

Click to view full plan

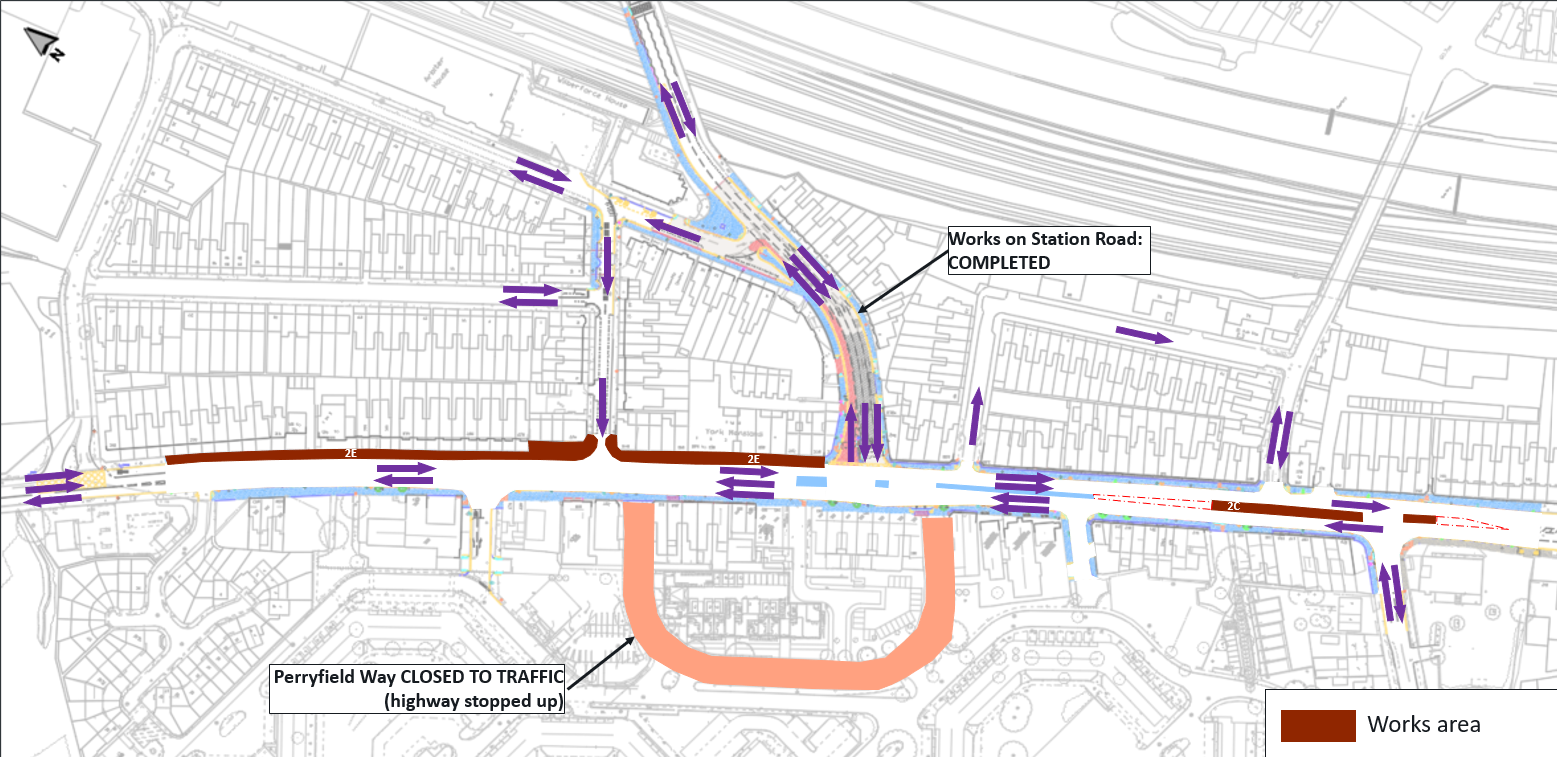

Construction progress plan thumbnail for Oct 2025

Oct 2025

Click to view full plan

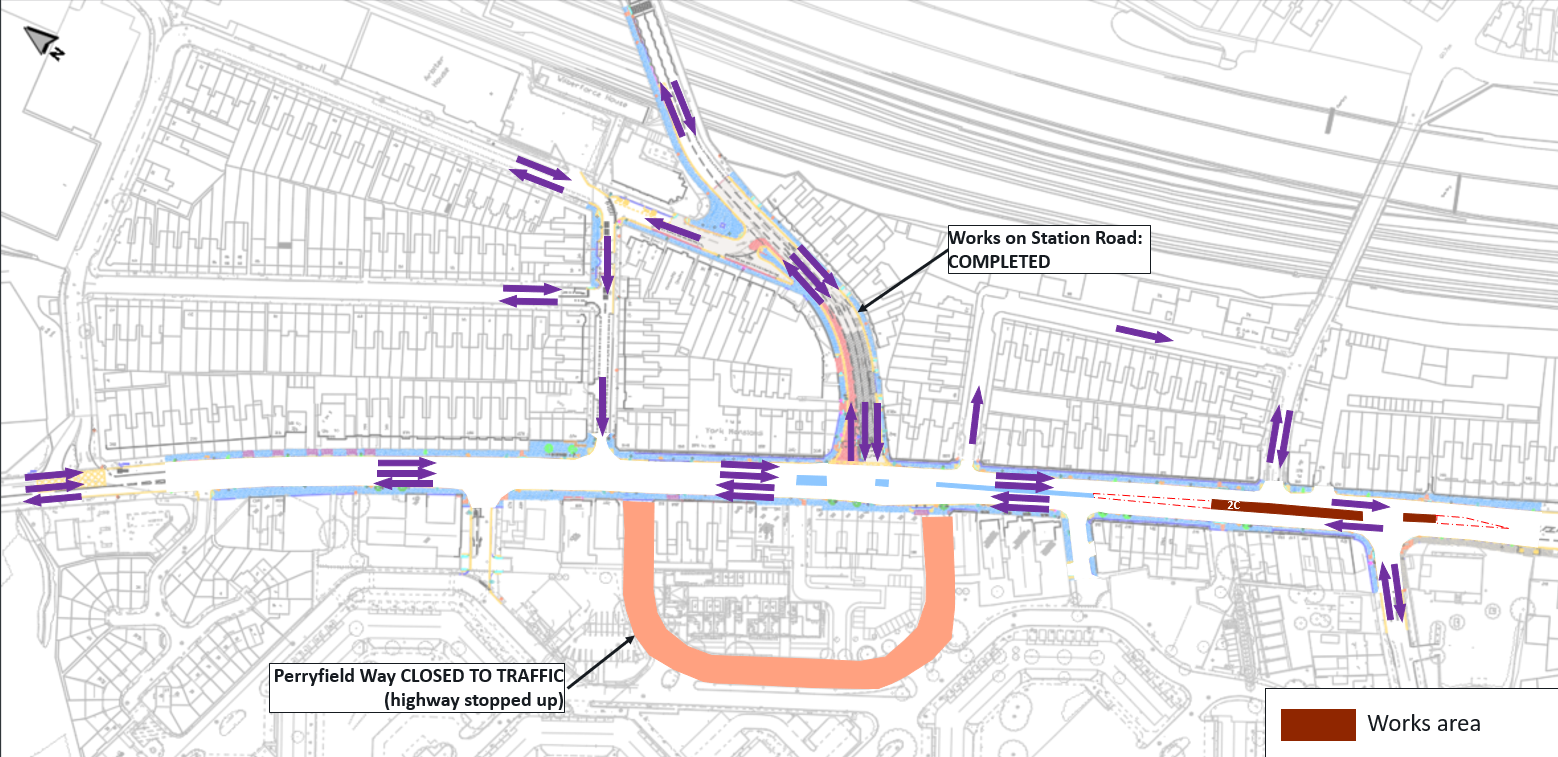

Construction progress plan thumbnail for Nov 2025

Nov 2025

Click to view full plan

Construction progress plan thumbnail for Nov 2025

Nov 2025

Click to view full plan

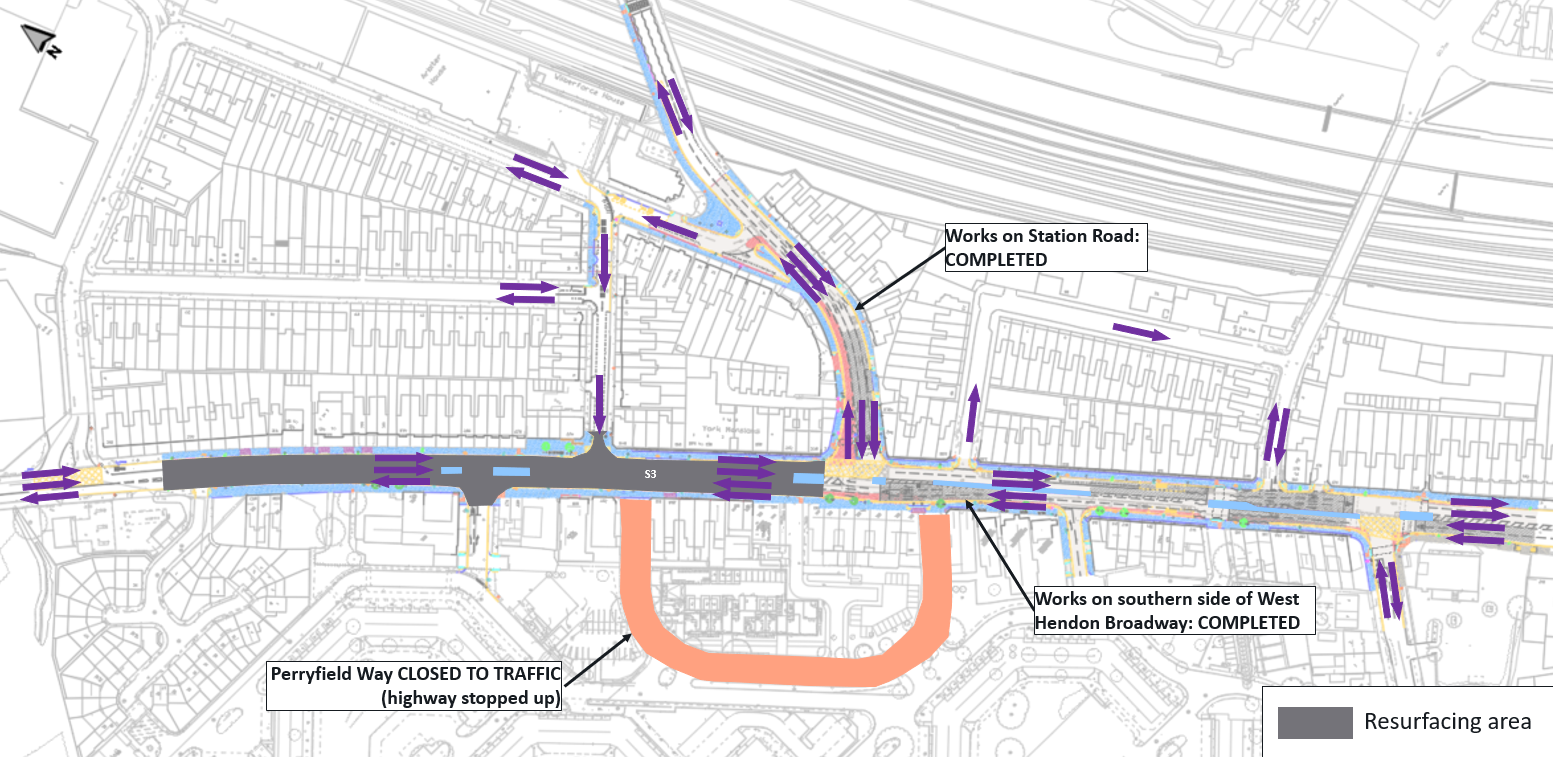

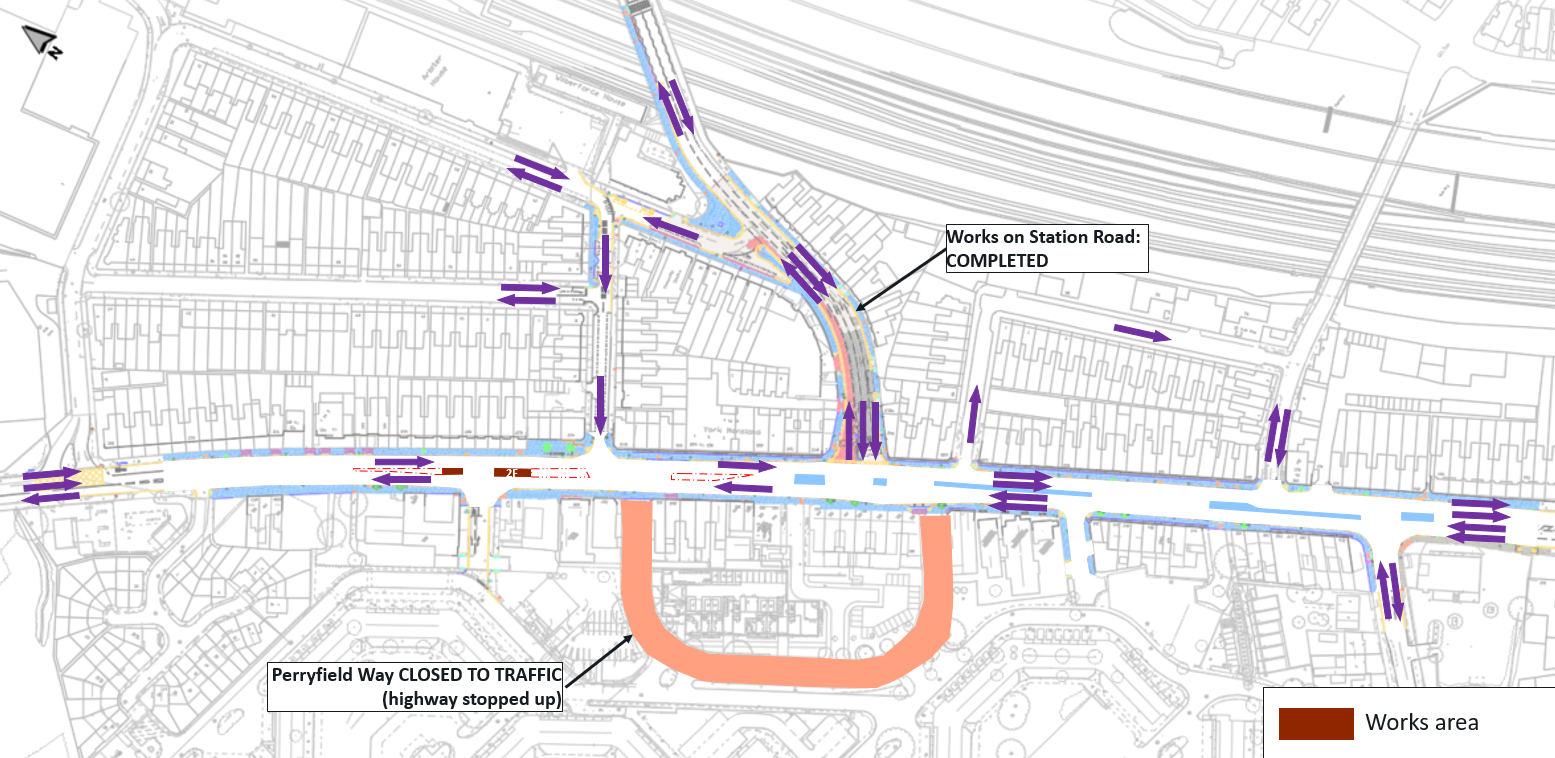

Construction progress plan thumbnail for Jan 2026

Jan 2026

Click to view full plan

Questions About Our Progress?

Our project team provides regular updates and is available to discuss any questions about current or upcoming work.
